Fairview Boulevard (State Route 100) Improvements

Williamson County
Map showing terminus of TDOT's SR 100 (Fairview Boulevard) improvements project

The Tennessee Department of Transportation (TDOT) is constructing an improvement project along State Route 100 (Fairview Boulevard) in Fairview. Project components include the installation of curb and gutter, a storm drainage system, and 5-foot sidewalks in the following areas:

  • From Fairview Community Center to King Road: Sidewalks on the westbound side of SR 100
  • From King Road to Cumberland Drive/Crow Cut Road: Sidewalks on both sides of SR 100
  • From Cumberland Drive/Crow Cut Road to Bowie Lake Road: Sidewalks on the westbound side of SR 100

Improvements also include the installation of dedicated left turn lanes, a new traffic signal, and school zone flashing signage at Crow Cut Road and Cumberland Drive. The project aims to improve pedestrian connectivity and enhance safety along a key corridor that serves schools, recreational facilities, and commercial areas.

Current Status: Under construction.

Construction start: September 2025

Estimated completion*: Substantial completion by end of October 2026; crosswalk and permanent signal at Crow Cut Road & Cumberland Drive by end of November 2026.

Funding Type: Federal and State

*Subject to change.

cone

Traffic Impacts

Weekly traffic impacts will be posted on the Middle Tennessee Lane Closure report posted on the TDOT Newsroom.

As work on this project continues, two phases of traffic control will take place, with each phase shifting traffic on one side of SR 100 to allow for sidewalk construction. Scheduled construction impacts during the school year will consist of intermittent lane closures on SR 100 between 9 a.m. and 3 p.m., with no night work permitted. When school is not in session (June-July), work will be permitted 8:30 a.m. to 3:30 p.m. No scheduled full closures of Cumberland Drive will occur when school is in session.

magnifying glass

History and Background

State Route 100 throughout the City of Fairview has a blend of sidewalk and non-sidewalk sections between the Fairview Community Center and Bowie Lake Drive. Additionally, Fairview High School, Middle School and Elementary School are all within the proximity of Cumberland Drive. TDOT, in coordination with the City of Fairview, have bundled two projects for construction, the sidewalk construction between the Community Center and Bowie Lake Road, and the signalization of State Route 100 at Cumberland Drive.


pin


Key Project Milestones

SectionProject InitiatedRight-of-Way Acquisition AuthorizedLet to Construction
Intersection at Cumberland DriveJune 2018September 2023May 2025
Sidewalk from FCC to Bowie Lake RoadJanuary 2018March 2019May 2025
people

Public Involvement and Engagement

Subscribe to this project's newsletter here.

Latest newsletter: September 2026 (PDF).

May 2024 – TDOT/City of Fairview Town Council Update
September 2024 – TDOT presents project updates at the Fairview Annual Address
May 2019 - TDOT Neighborhood Meeting for Right-of-Way Acquisition (PDF)



globe



Environment

There are no major environmental impacts associated with this project. Erosion Prevention and Sediment Control best management practice measures will be installed and maintained during roadway construction to minimize the likelihood of sediment and debris deposition from the project site. Two streams and a wetland in the project limits will be preserved.

paper


Project Materials

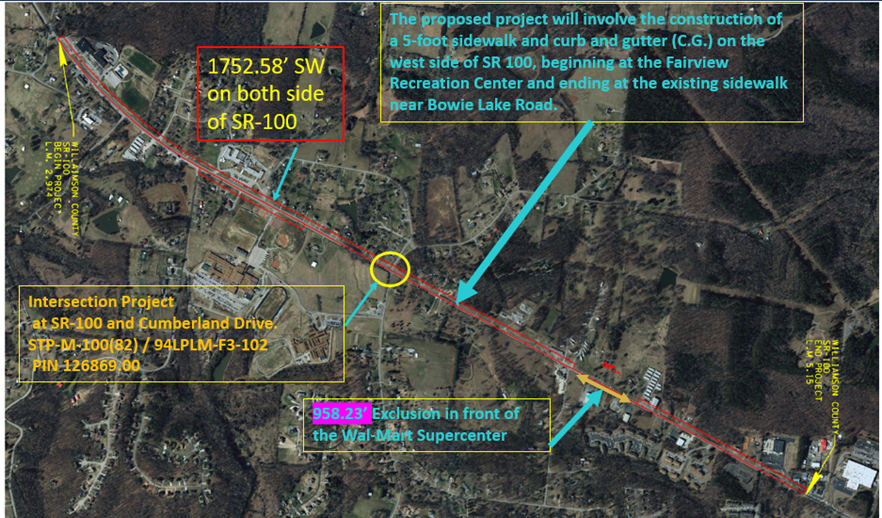

Detailed project map of terminus.

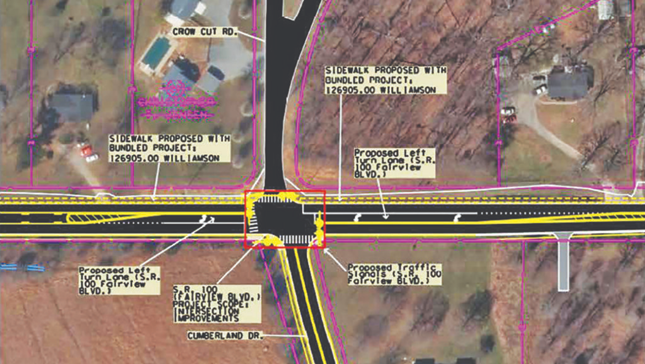

Rendering showing project plans where sidewalks will be

Project Contacts

Erin Zeigler
TDOT Region 3 Regional Communications Officer (Media)
Phone: 629.277.2458
Email: erin.zeigler@tn.gov

Halen Tyler
TDOT Region 3 Communications Specialist (Media/Website)

Phone: 629.239.8524
Email: Halen.Tyler@tn.gov

Osama Mohamed
TDOT Region 3 Team Lead (Construction)
Phone: 615.350.4458
Email: osama.mohamed@tn.gov

Taylor McAnally
TDOT Region 3 District Engineer (Construction)
Phone: 615.350.4349
Email: taylor.mcanally@tn.gov
