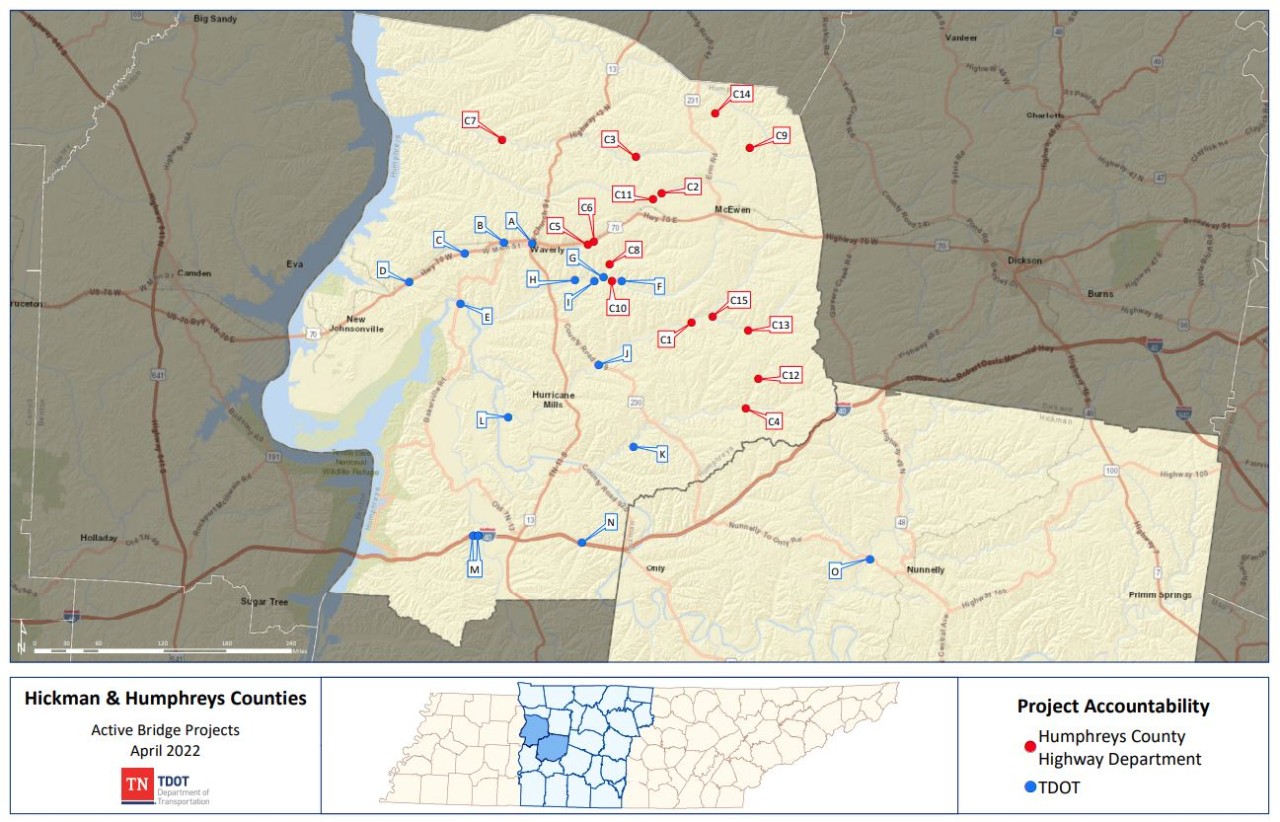

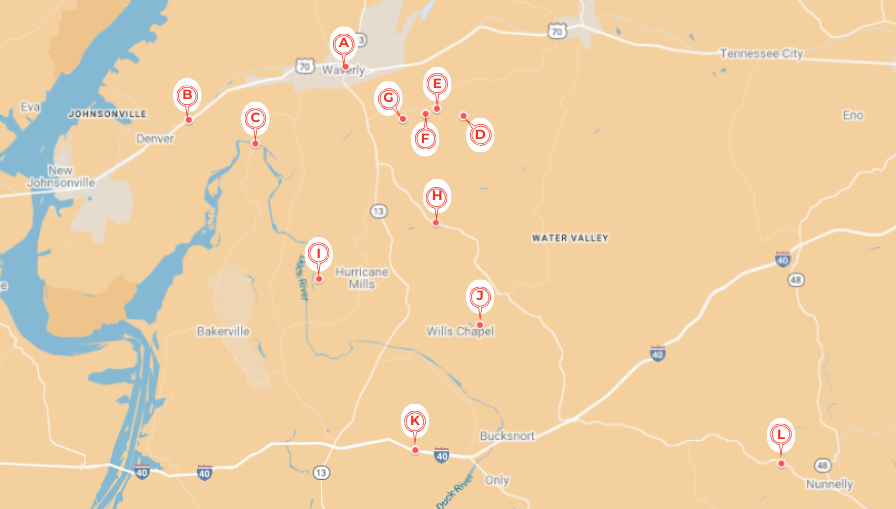

2021 Flood Recovery - Humphreys & Hickman County Bridges

This project includes bridge repair and replacements that were impacted or caused by the 2021 flood.
Current Status: See the Project Milestones section to view the current status of each bridge.

Key Project Milestones
LOCATION |
SCOPE OF WORK |
ANTICIPATED LETTING |
Humphreys Co. - SR-13, Church St (Viaduct bridge) |
Bridge Replacement |
Summer 2023
|
Humphreys Co. - Waverly Bypass/US-70 |
Fence Replacement
|
In Progress
|
Humphreys Co. - Various State Routes |
Guardrail Repair/Replacement |
Completed |
Humphreys Co. - US-70/SR-1 - Bridges over Trace Creek (near Scepter Rd) |
Bridge Replacement |
Winter 2022-2023 |
Humphreys - Bakerville Road - Bakerville Road over Duck River
|
Bridge Replacement
|
Summer 2023
|
Humphreys Co. - East Blue Creek Road Bridge over Blue Creek
|
Bridge Replacement - Construction of a 2-lane, 100-foot three span prestressed concrete girder bridge with shoulders |
Winter 2022/23
|
Humphreys Co. East Blue Creek Road Bridge over Blue Creek |
Bridge Replacement - Construct a 2-lane 100-foot three span prestressed concrete girder bridge with shoulders. |
Winter 2022/23
|
Humphreys Co. - Tatum Lane bridge over Blue Creek (off of East Blue Cr Rd)
|
Bridge Replacement. The proposed structure will be a two span pre-stressed concrete structure, with a proposed alignment shift of twenty-one feet to the east. The project will also include utility relocation
|
Fall 2022
|
Humphreys Co. - Weed Lane, Bridge over Blue Creek (Off of East Blue Cr Rd)
|
Bridge replacement
|
Spring 2023
|
Humphreys Co. - SR 230 over Hurricane creek and Overflow (Toward Bold Springs)
|
Bridge replacement |
Active Completion Date: summer 2023
|
Humphreys - Tumbling Creek Rd, bridge over Tumbling Creek
|
Bridge Replacement. Construction of a 2-lane 140-foot three-span prestressed concrete girder bridge with shoulders.
|
Spring 2023
|
Humphreys - Cedar Grove Road over Hurricane Creek (west of Loretta Lynn's Ranch)
|
Bridge Replacement. The proposed bridge is to be a three-hundred (300) feet long, three (3) span concrete beam bridge with an out-to-out width of twenty-five (25) feet three (3) inches. The proposed grade of the bridge will be approximately one (1) foot higher than the existing structure and the exiting centerline will be maintained.
|
Spring 2024
|
Humphreys Co. - I-40 Bridges over Buffalo River & Squeeze Bottom Lane
|
Bridge replacement |
Winter 2022-2023
|
Humphreys Co. - Crockett Murphree Lane, (Mile Marker 145 - Bridge over I-40)
|
Bridge Replacement
|
Summer 2024
|
Hickman - SR-230 (between Bucksnort and Nunnelly)
|
Bridge replacement |
"Active Comp Date 6/30/23"
|
Project Contacts
Community Relations Officer:
Rebekah Hammonds;
Rebekah.Hammonds@tn.gov
*Subject to change
