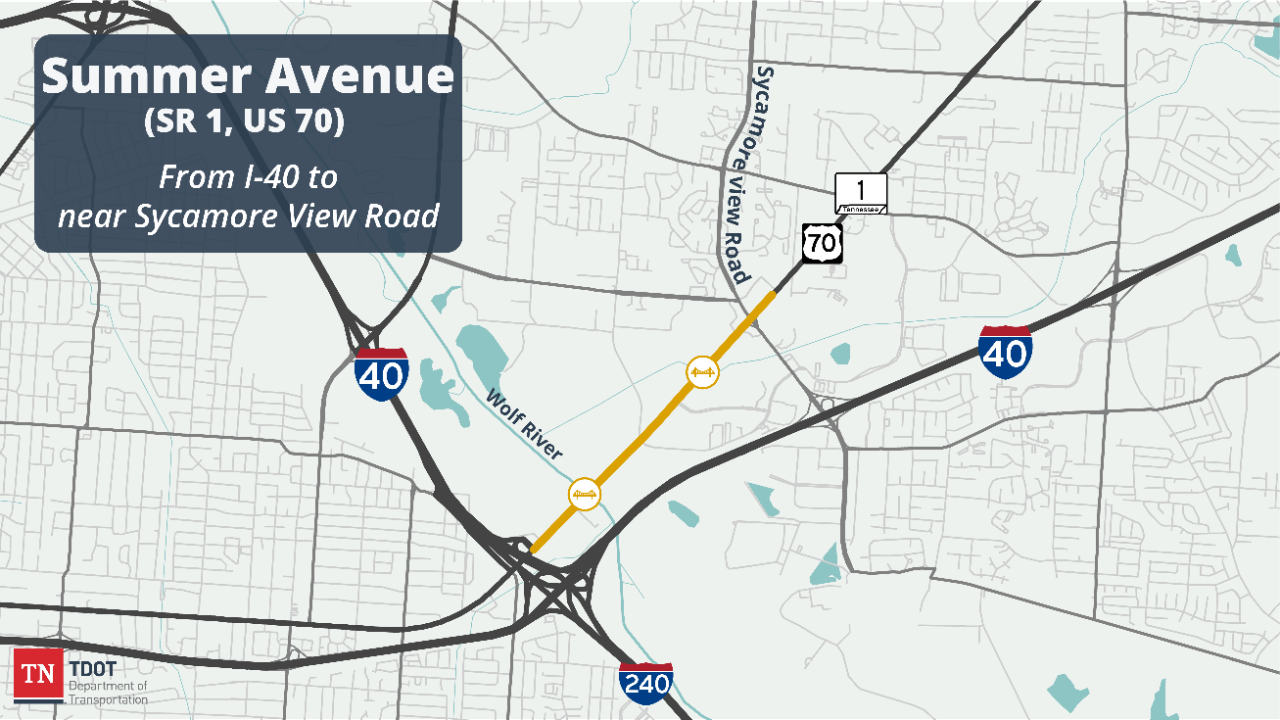

Summer Avenue (State Route 1, US 70)

Shelby County
Shelby SR 1

The Tennessee Department of Transportation (TDOT) is proposing to widen Summer Avenue (State Route 1, US 70) from near I-40 to north of Sycamore View Rd. Currently, Summer Avenue consists of four travel lanes with a center turn lane. This project will widen Summer Avenue to include six travel lanes, a center turn lane, and bike lanes.

This project will increase the capacity of Summer Avenue and reduce congestion for current and future local and regional travelers. As part of this project, the existing bridge spans over the Wolf River and Fletcher Creek, which are currently seismically deficient, will be replaced.

This project is identified for funding in TDOT's 10-Year Project Plan, with construction scheduled in Fiscal Year 2025.

Current Status: The project team is currently finalizing construction documents.

Estimated construction start: 2025.

Estimated completion*: TBD

Funding Type: TDOT anticipates that a portion of this project will be funded through the Transportation Modernization Fund.

magnifying glass


History and Background

The proposed project is 1.87 miles in length and will consist of six 11-ft. travel lanes (3 in each direction), a 12-ft. center two-way left turn lane, and two 4-ft. bike lanes with a 3-ft. buffer along with curb and gutter in both directions, all within 116 feet of right-of-way (ROW). Summer Avenue's pavement will be milled and overlaid from White Station Road to the beginning of the project near the I-40 ramp to re-stripe the roadway to carry the proposed bike lane to White Station Road. The project will also replace the bridges over Wolf River and Fletcher Creek. The bridge over Wolf River will include a 12-ft. multi-use path to coincide with improvements to be constructed as part of the Wolf River Greenway. The improvements will include dual left turn lanes at the intersection of Bartlett Road and the intersection of Sycamore View Road. Roadway lighting is proposed along the route, and upgraded signals will be constructed along Summer Avenue at the intersections of White Station Road, Bartlett Road/Shelby Oaks Drive and Sycamore View Road.

TDOT first identified the need to widen Summer Avenue from I-40 to Elmore Road as part of the Accelerated Primary Highway Plan that accompanied the gasoline tax increase passed by the 94th General Assembly in 1986. Background data on the project indicated an insufficient level of service for the facility. An Advanced Planning Report was developed and approved in 1997 and addressed improvements needed to the facility to increase the level of service. Survey and design began immediately, and an Environmental Assessment (EA) was approved on March 9, 1998. A public hearing was held in May 1998 to give the public an opportunity to review and comment on the proposed project. Based on the EA, the Federal Highway Administration (FHWA) approved a Finding of No Significant Impact (FONSI) on May 10, 1999. The project was authorized to proceed to the right-of-way (ROW) phase in August 1999, and ROW acquisition began in early 2000.

TDOT identified this project as a candidate for the Expedited Project Delivery (EPD) program, aimed at identifying and recommending improvement options that are feasible, cost effective and provide improved safety and mobility. In 2014, TDOT placed the project on hold to conduct an EPD review. In late 2016, the EPD review was completed for the project. As mentioned above, for construction purposes the project was separated into two sections: from I-40 to 0.1 mile north of Sycamore View Road and from 0.1 mile north of Sycamore View Road to 0.1 mile north of Elmore Road. The EPD review addressed both sections of the project. The approved EPD recommendation was to proceed with the original proposed seven-lane curb and gutter typical section.

A reevaluation of the EA/FONSI with a focus on the section of Summer Avenue from I-40 (east of Macon Road) to 0.1 mile north of Sycamore View Road was approved by FHWA on July 21, 2021. Another reevaluation was performed and approved on May 4, 2022.

The overall project is listed in the Memphis MPO’s Livability 2050: Regional Transportation Plan (RTP), adopted September 12, 2019. The first segment, from I-40 to 0.1 mile north of Sycamore View Road, is identified in the RTP for horizon year 2021-2025. The second segment, from 0.1 mile north of Sycamore View Road to 0.1 mile north of Elmore Road, is identified for horizon year 2026-2030.  The first segment is currently in TDOT’s Three-Year Plan and is scheduled for construction in Fiscal Year 2025.

people


Public Involvement and Engagement

Upon approval of the Environmental Assessment (EA) on March 9, 1998, a public hearing was held as a part of the National Environmental Policy Act (NEPA) environmental review process to present the EA to the public and solicit input. The hearing was held on May 12, 1998, in the Shelby Oaks Elementary School Cafeteria, at 6053 Summer Avenue in the project area. As noted in the FONSI, there were 54 public attendees and 17 individuals provided comments. Most of the comments offered no clear support or opposition to the project; rather, the comments were directed to personal issues related to impacted properties. Two individuals stated their support for the project and one person expressed opposition to the project.

A right-of-way (ROW) meeting was held on November 16, 1999, in the Shelby Oaks Elementary School Cafeteria, at 6053 Summer Avenue.  The purpose of this meeting was to provide information to the affected property owners concerning the ROW acquisition process, explain the project plans, and to answer questions about the project and ROW acquisition process.

map


Project Imagery & Visuals

Google Earth Map of Project Corridor

globe


Environment

An Environmental Assessment (EA) was approved by the Federal Highway Administration (FHWA) on March 9, 1998. Based on the EA, FHWA approved a Finding of No Significant Impact (FONSI) on May 10, 1999.

A reevaluation of the EA/FONSI with a focus on the section of Summer Avenue from I-40 to 0.1 mile north of Sycamore View Road was approved by FHWA on July 21, 2021. Another reevaluation was performed and approved on May 4, 2022.

pin



Key Project Milestones



Advanced Planning Report

 January 10, 1997

Approved Environmental Assessment

 March 9, 1998

Public Hearing

 May 12, 1998

ROW funding authorization

 August 12, 1999

ROW plans distribution

 August 26, 1999

ROW meeting

 November 16, 1999

Construction reevaluation of the EA/FONSI

 July 21, 2021

Construction reevaluation of the EA/FONSI

 May 4, 2022

Construction

 (Forecasted) First quarter of 2025

paper

Project Contacts

Nichole Lawrence
TDOT Region 4 Regional Communications Officer (Media)
Phone: 731.935.0318
Email: Nichole.Lawrence@tn.gov

Seth Hendren
TDOT Region 4 Project Management
Phone: 731.935.0143
Email: Seth.Hendren@tn.gov
